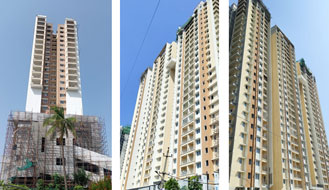

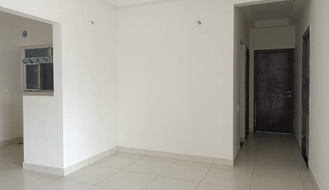

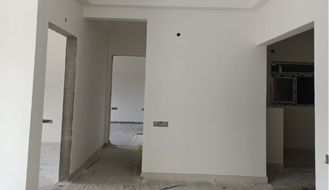

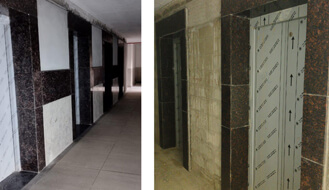

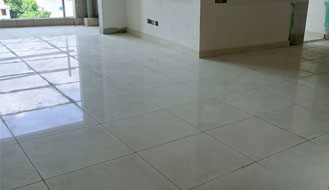

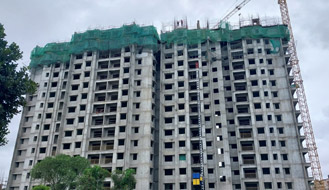

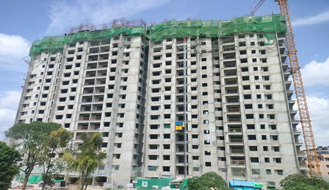

September 2024

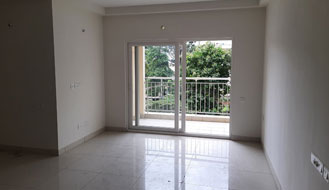

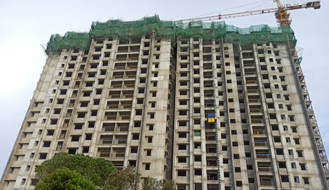

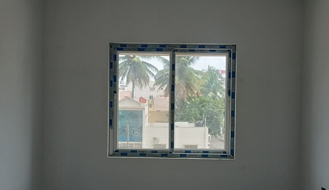

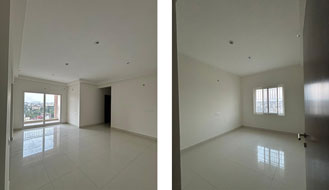

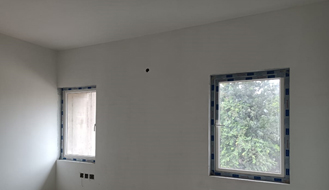

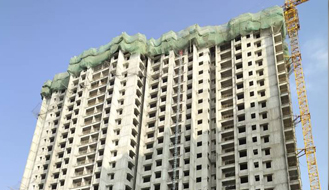

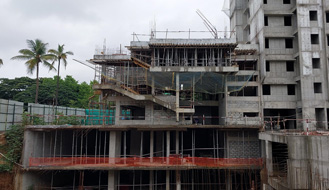

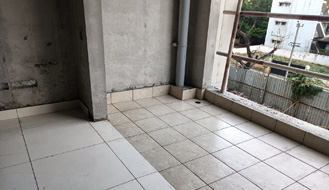

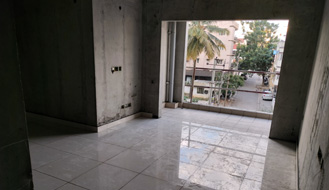

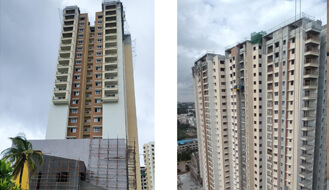

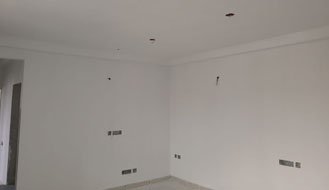

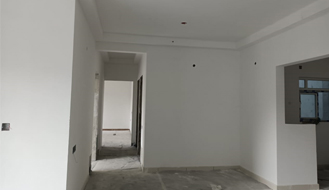

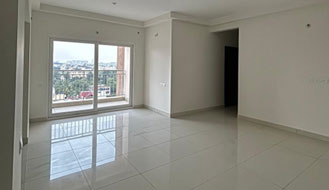

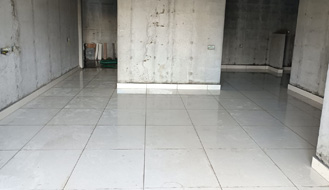

Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress

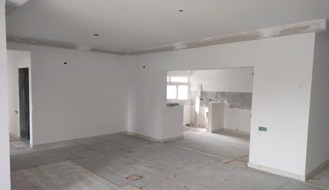

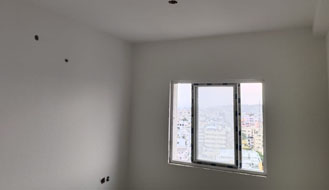

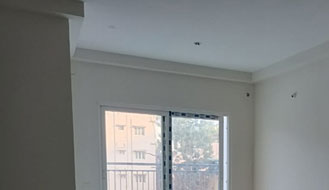

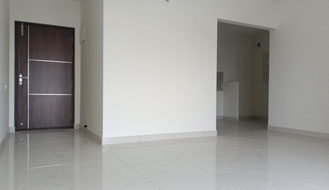

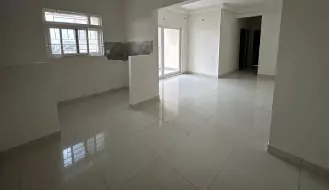

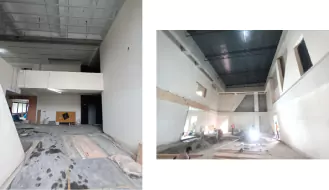

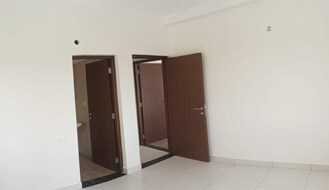

Brigade Komarla Heights Tower B : Finishing Works

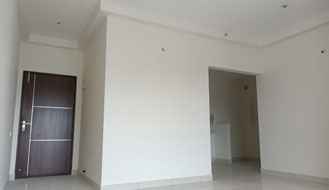

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works

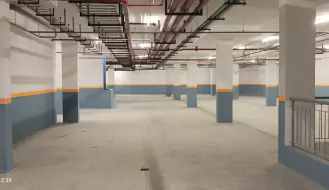

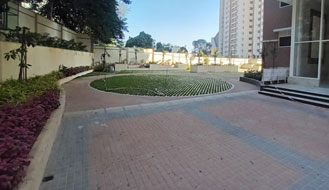

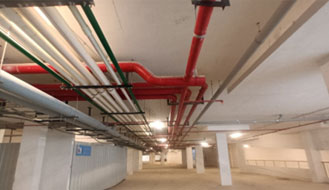

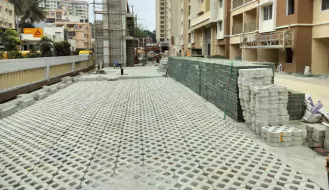

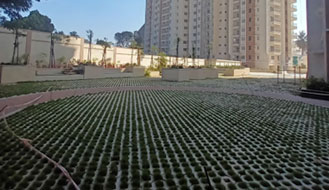

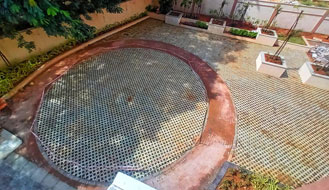

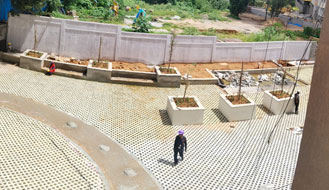

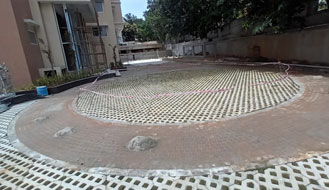

Brigade Komarla Heights Tower B : Common area progress
Brigade Komarla Heights Tower B : Common area progress

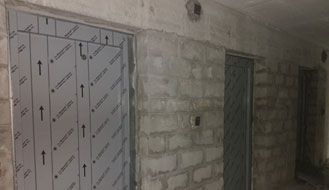

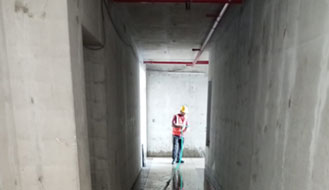

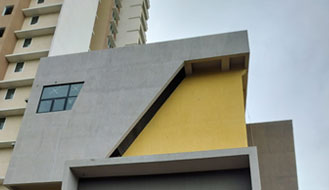

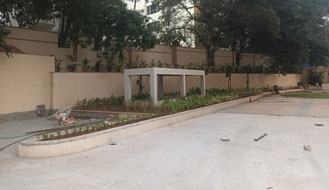

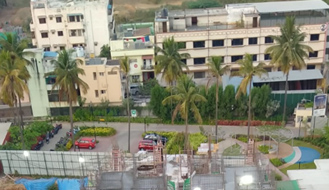

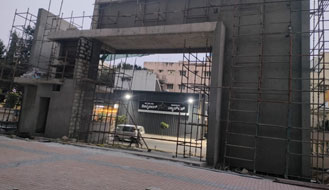

Brigade Komarla Heights Tower B : Entry portal works are in progress

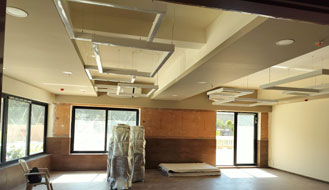

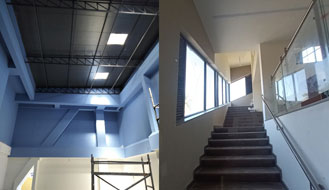

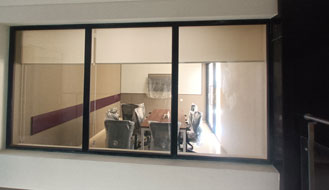

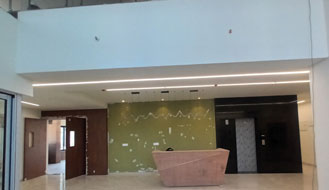

Brigade Komarla Heights Tower B : Club House Interior Works are in progress
August 2024

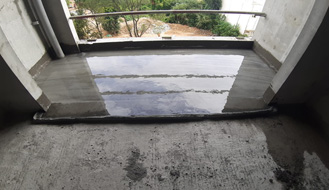

Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress

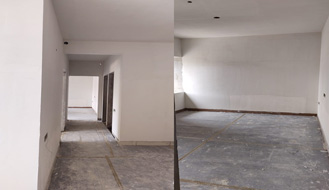

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Towers A & B : Common area progress
Brigade Komarla Heights Towers A & B : Common area progress
Brigade Komarla Heights Tower Club House : Interior Works are in progress
July 2024
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Common area progress

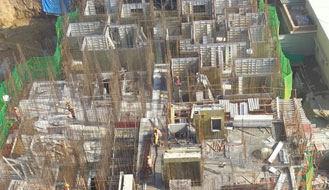

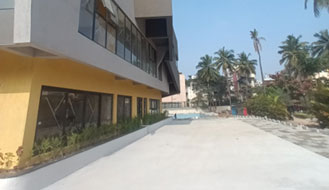

Brigade Komarla Heights Tower B : Club House External plastering & Painting works are completed
June 2024
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress

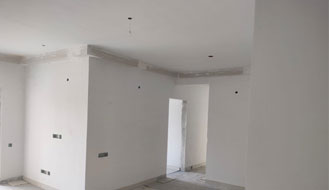

Brigade Komarla Heights Tower B : Finishing Works in Tower B
Brigade Komarla Heights Tower B : Finishing Works in Tower B

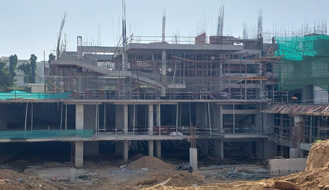

Brigade Komarla Heights Tower A & B : Common area progress
Brigade Komarla Heights Tower A & B : Common area progress

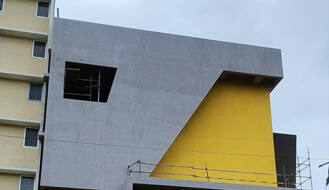

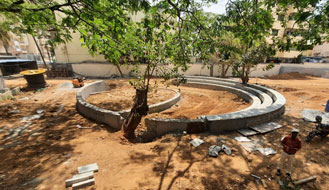

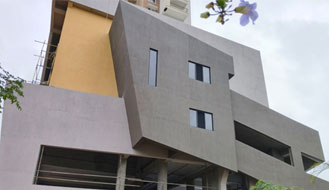

Club House Terrace & Above terrace works completed, External plastering & Painting works are in progress
Brigade Komarla Heights Tower B : Milestone Release On commencement of Painting 18 to 25 Floor
Brigade Komarla Heights Tower B : Milestone Release On commencement of Painting 18 to 25 Floor
Brigade Komarla Heights Tower B : Milestone Release – On commencement of Installation of Lifts
Brigade Komarla Heights Tower B : Milestone Release – On commencement of Installation of Lifts
May 2024
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress
Brigade Komarla Heights Tower B : Above terrace Finishing works and External painting works are in progress
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works

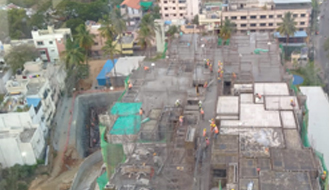

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Towers A & B : Common area progress
Brigade Komarla Heights Tower B : Club House Terrace & Above terrace works completed, External plastering & Painting works are in progress
April 2024

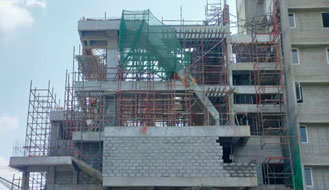

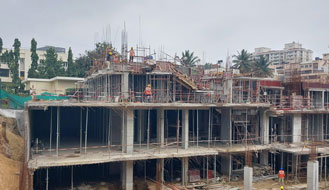

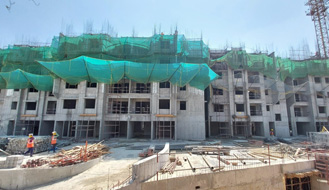

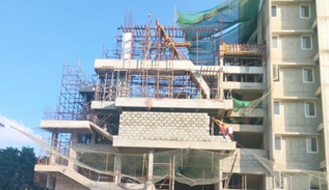

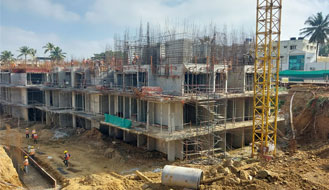

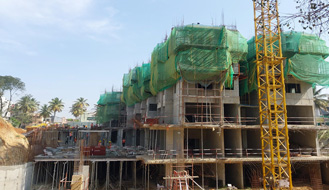

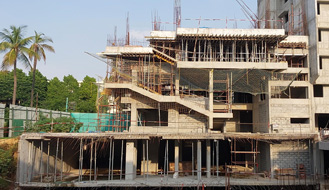

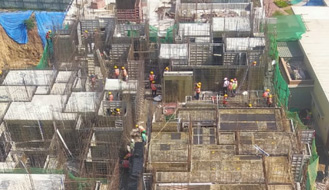

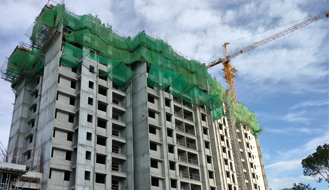

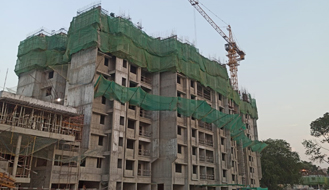

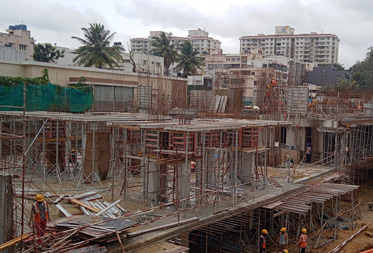

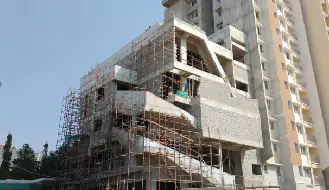

Brigade Komarla Heights Tower B Structure : Above terrace structure works and External painting works are in progress

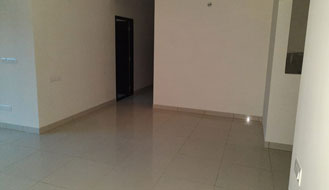

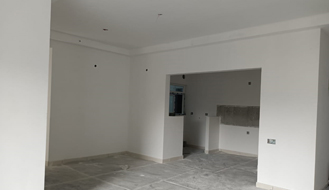

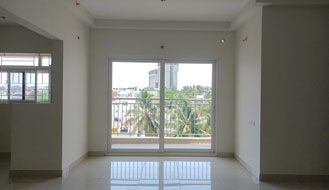

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works

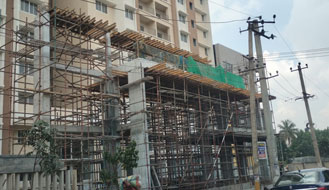

Brigade Komarla Heights Tower B : Lift installation works are in progress
Brigade Komarla Heights Tower B : Club House Terrace & Above terrace works completed, External plastering works are in progress
March 2024
Club House Terrace & Above terrace works completed, Block work & plastering works are in progress

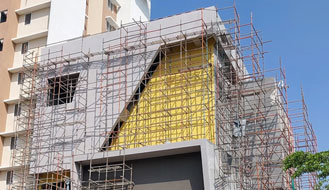

Brigade Komarla Heights Tower B : Lift installation works are in progress

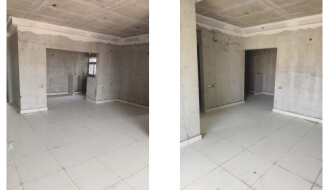

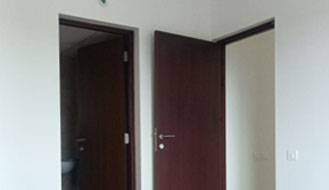

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Above terrace structure works and External painting works are in progress
Brigade Komarla Heights Tower B : Milestone Release On Commencement of Flooring 18th to 25th Floor
Brigade Komarla Heights Tower B : Milestone Release On Commencement of Flooring 18th to 25th Floor

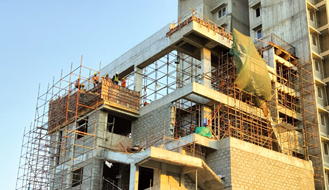

February 2024

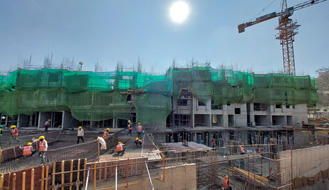

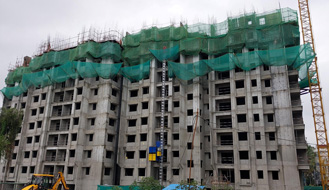

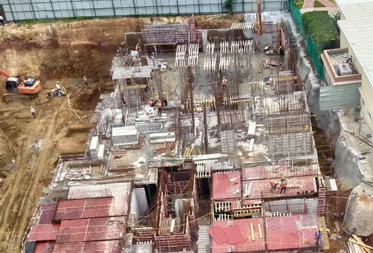

Brigade Komarla Heights Tower B Structure : Terrace floor completed Above terrace works & External painting works are in progress

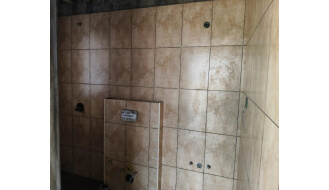

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Clubhouse Terrace slab completed. Above terrace works, Block work & plastering works are in progress
Brigade Komarla Heights Tower B : Milestone Release On Commencement of painting - 9 to 17 Floor
January 2024
Brigade Komarla Heights Tower B Structure : Terrace floor completed Above terrace works & External painting works are in progress

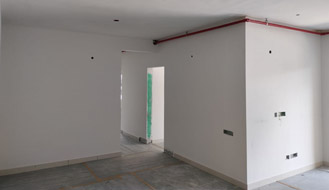

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Club House Structure : Terrace slab completed. Above terrace works are in progress
December 2023

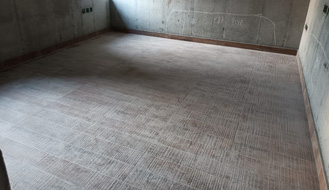

Brigade Komarla Heights Tower B : Terrace floor completed Above terrace works are in progress

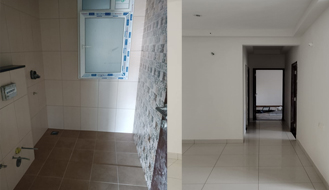

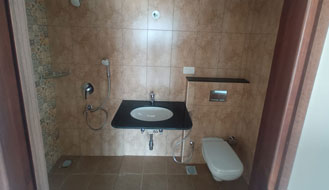

Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Club House Structure - Terrace floor work in progress
Brigade Komarla heights Tower B : Milestone Release On commencement of flooring 9 to 17
Brigade Komarla heights Tower B : Milestone Release On commencement of flooring 9 to 17
November 2023
Brigade Komarla Heights Tower B : Milestone Release On Casting of Terrace Slab
Brigade Komarla Heights Tower B Structure : Terrace floor completed Above terrace works are in progress
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Finishing Works
Brigade Komarla Heights Tower B : Milestone Release on Commencement of Painting GF to 8
Brigade Komarla Heights Tower B : Milestone Release on Commencement of Painting GF to 8
October 2023

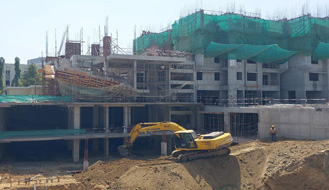

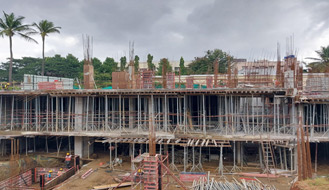

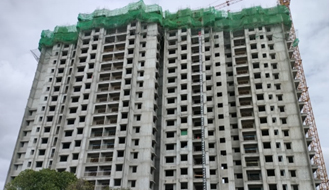

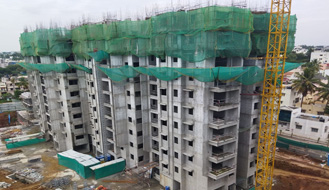

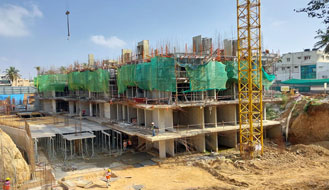

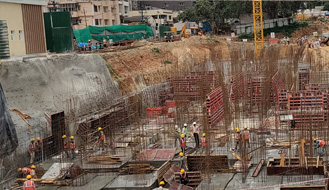

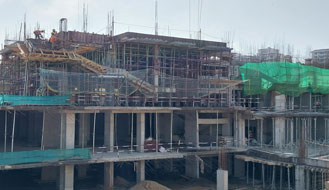

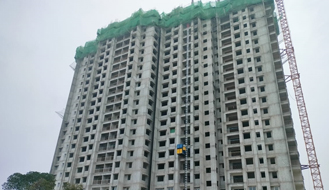

Brigade Komarla Heights Tower B Structure : 22nd floor completed 23rd floor in progress

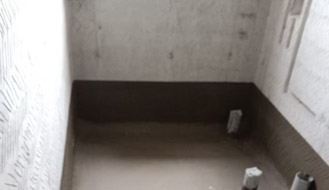

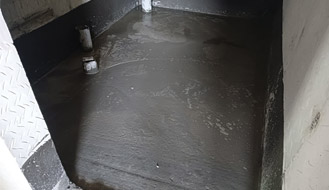

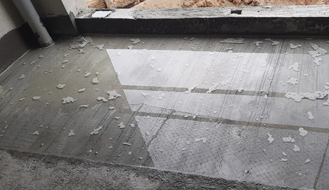

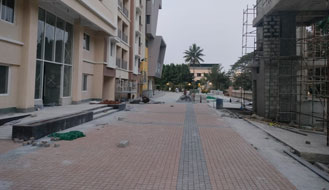

Brigade Komarla Heights Tower B : Water proofing 12th floor completed, 13th & 14th floor work in progress
Brigade Komarla Heights Tower B : Painting works in progress up to 8th floor
Brigade Komarla Heights Tower B : UPVC windows fixing completed up to 5th floor
September 2023

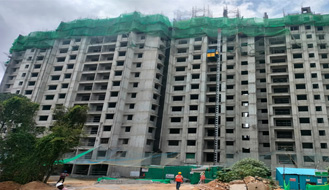

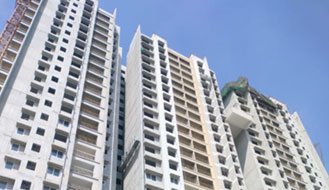

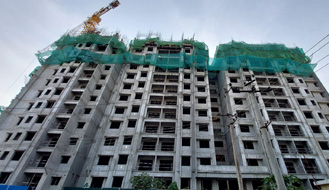

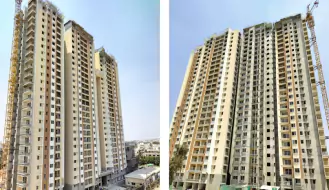

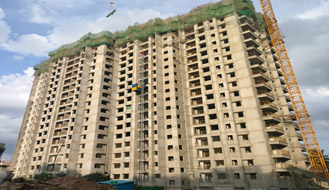

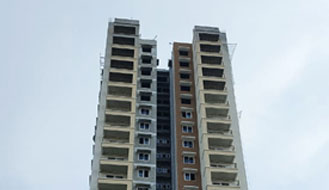

Brigade Komarla Heights Tower B : View From West Side (21st floor slab 100% completed 22nd floor slab work in progress)
Brigade Komarla Heights Tower B : Water proofing 10th floor completed, 11th & 12th floor work in progress

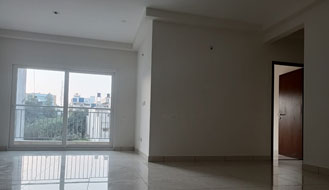

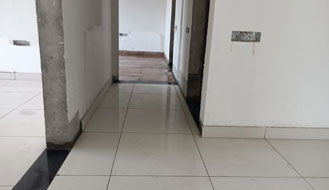

Brigade Komarla Heights Tower B : Tiling 8th floor completed. 9th floor & 10th floor work in progress
Brigade Komarla Heights Tower B : Painting works in progress up to 6th floor
Brigade Komarla Heights Tower B : Milestone Release On casting of twentieth floor slab
August 2023

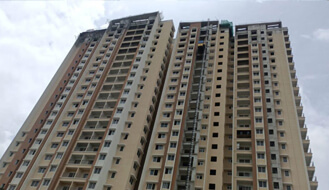

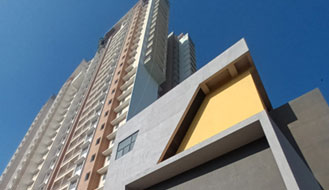

Brigade Komarla Heights Tower B : View From West Side (19th floor 100% completed 20th floor work in progress)
Brigade Komarla Heights Tower B : Finishing Works and Water proofing 7th floor completed, 8th floor work in progress
Brigade Komarla Heights Tower B : Tiling 6th floor completed and 7th floor work in progress
Brigade Komarla Heights Tower B : Finishing Works and Painting works in progress up to 5th floor
July 2023

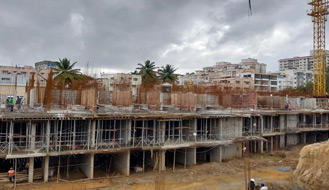

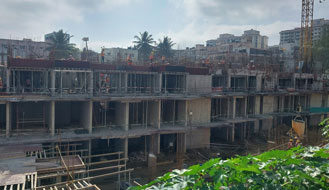

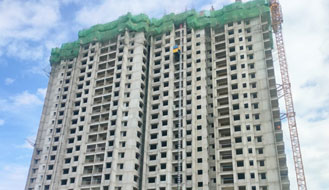

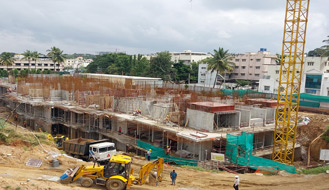

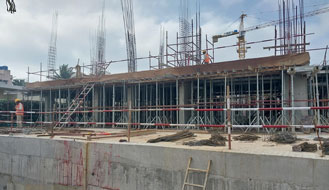

Brigade Komarla Heights Tower B Structure : View From West Side (17th Floor 100% Completed 18th Floor work in progress)
Brigade Komarla Heights Tower B : Finishing Works. And Water proofing works in progress up to 6th floor
Brigade Komarla Heights Tower B : Tiling Works in progress up to 5th floor
Brigade Komarla Heights Tower B : Finishing Works. And Painting works in progress up to 3rd floor
Brigade Komarla Heights Tower B : Milestone Release – On Casting of 16th Floor Slab
Brigade Komarla Heights Tower B : Milestone Release – On Casting of 16th Floor Slab
June 2023
Brigade Komarla Heights Tower B : View From West Side (15th floor 100% completed 16th floor work in progress)
Brigade Komarla Heights Tower B : Finishing Works. Water proofing works in progress up to 6th floor
Brigade Komarla Heights Tower B : Tiling Works in progress up to 4th floor
Brigade Komarla Heights Tower B : Finishing Works. Painting works in progress up to 3rd floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release - On Commencement of Flooring Ground to 08th Floor
Brigade Komarla Heights Tower B : Milestone Release – On Casting of 12th Floor Slab
May 2023

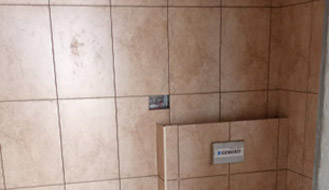

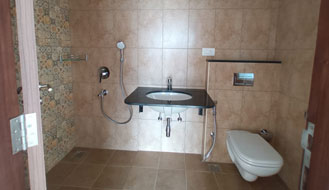

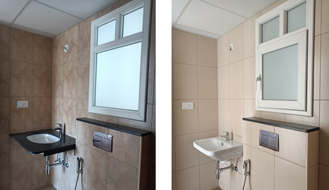

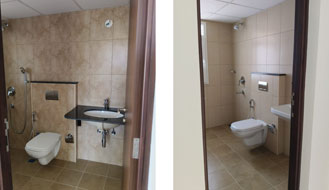

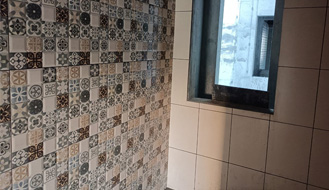

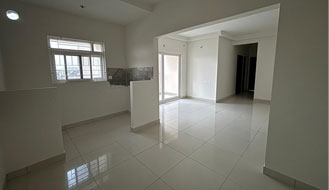

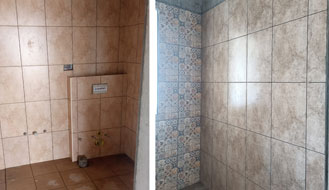

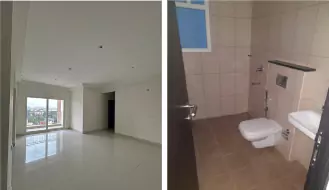

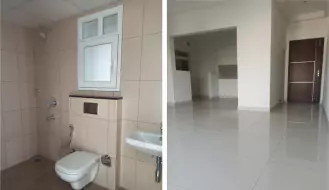

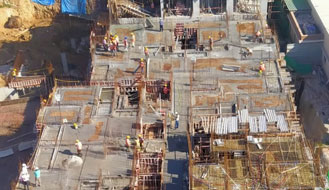

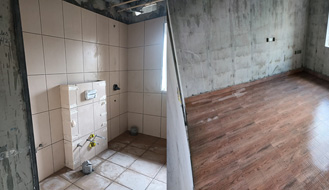

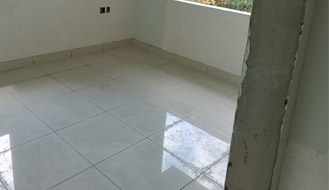

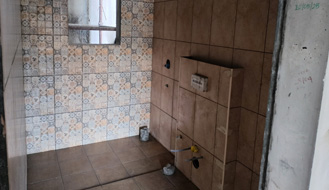

Brigade Komarla Heights Tower B : Internal toilet dado and floor tiles works are in progress
Brigade Komarla Heights Tower B : Internal toilet dado and floor tiles works are in progress
Brigade Komarla Heights Tower B (view from west side) : 12th floor slab concreting 100% completed & 13th floor works are in progress
Brigade Komarla Heights Tower B (view from south side) : 12th floor slab concreting 100% completed & 13th floor works are in progress
Brigade Komarla Heights Tower B (view from East) : 12th floor slab concreting 100% completed & 13th floor works are in progress
Brigade Komarla Heights Club House (view from West side) : Third floor slab works 100% completed

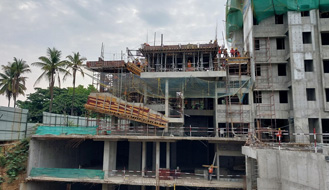

April 2023
Brigade Komarla Heights Tower B (view from west side): 10th floor slab concreting 100% completed & 11th floor works are in progress
Brigade Komarla Heights Tower B (view from south side) : 10th floor slab concreting 100 % completed & 11th floor works are in progress
Brigade Komarla Heights Tower B (view from top) : 10th floor slab concreting 100% completed & 11th floor works are in progress
Brigade Komarla Heights Club House (view from West side) : Third floor slab works 100% completed
Brigade Komarla Heights Tower B : Milestone Release – On Casting of 08th Floor Slab
Brigade Komarla Heights Tower B : Milestone Release – On Casting of 08th Floor Slab
March 2023

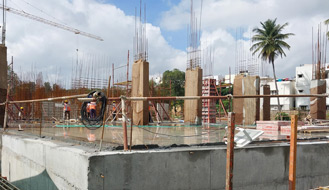

Komarla Heights Tower B (view from west side) : 8th floor slab concreting completed & 9th floor works are in progress
Komarla Heights Tower B (view from south side): 8th floor slab concreting completed & 9th floor works are in progress
Komarla Heights Tower B (view from top) : 8th floor slab concreting completed & 9th floor works are in progress
Komarla Heights Club House (view from West side) : Third floor slab works in progress
February 2023
Komarla Heights Tower B (view from west side) : 5th floor slab concreting completed & 6th floor works are in progress
Komarla Heights Tower B (view from south side) : 5th floor slab concreting completed & 6th floor works are in progress
Komarla Heights Tower B (view from top) : 5th floor slab concreting completed & 6th floor works are in progress
Komarla Heights Club House (view from West side) : Second floor slab concreting completed & Third floor vertical columns casting works are in progress
Brigade Komarla Heights Tower B : Milestone Release - On Casting of 4th Floor Slab
Brigade Komarla Heights Tower B : Milestone Release - On Casting of 4th Floor Slab
January 2023
Komarla Heights Tower B (view from west side) : Second floor concreting WIP & 3rd floor works are in progress
Komarla Heights Tower B (view from south side) : Second floor concreting WIP & 3rd floor works are in progress
Komarla Heights Tower B (view from top) : Second floor concreting WIP & 3rd floor works are in progress
Komarla Heights Club House (view from West side) : Second floor slab completed & Third floor vertical columns casting works are in progress
July 2022

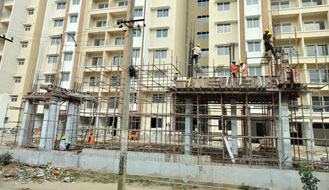

Komarla Heights Tower B : Milestone release- On casting of footing/raft
August 2022

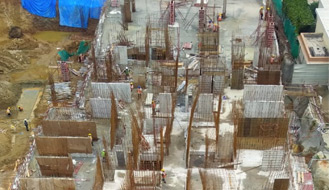

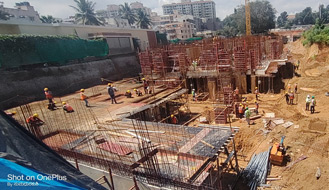

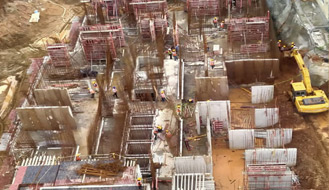

Komarla Heights Tower B (view from west side) : Upper basement slab concreting completed & Ground floor works are in progress
Komarla Heights Tower B (view from north side) : Upper basement slab concreting completed & Ground floor slab works are in progress. Club house substrcture & UB slab works are in progress
Komarla Heights Tower B (view from top) : Upper basement slab concreting completed & Ground floor slab works are in progress
September 2022

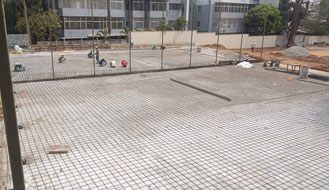

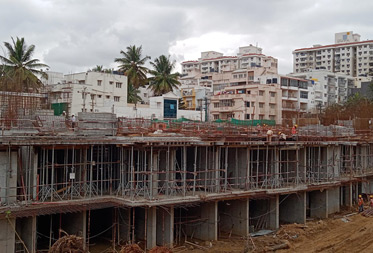

Komarla Heights Tower B (view from west side) : Ground floor slab works are in progress
Komarla Heights Tower B (view from south side) : Ground floor slab works are in progress
Komarla Heights Tower B (view from top) : Ground floor slab works are in progress
Komarla Heights Club House (view from north side) : Ground floor slab works are in progress
Komarla Heights Club House (view from west side) : Ground floor slab works are in progress
October 2022
Komarla Heights Tower B (view from west side) : Ground floor slab concreting completed & Stilt floor vertical shear wall works are in progress
Komarla Heights Tower B (view from south side) : Ground floor slab concreting completed & Stilt floor vertical shear wall works are in progress
Komarla Heights Tower B (view from top) : Ground floor slab concreting completed & Stilt floor slab works are in progress
Komarla Heights Club House (view from north side) : Ground floor slab concreting completed & stilt floor vertical columns casting works are in progress
Komarla Heights Club House (view from west side) : Ground floor slab concreting completed & stilt floor columns casting works are in progress
November 2022

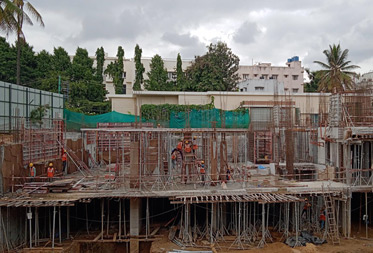

Tower B (view from west side) : First floor slab works are in progress
Tower B (view from south side) : First floor slab are in progress
Tower B (view from top) : First floor slab works are in progress
Club House (view from north side) : First floor slab concreting completed & Second floor vertical columns casting works are in progress
Club House (view from west side) : First floor slab concreting completed & Second floor columns casting works are in progress
December 2022
Brigade Komarla Heights Tower B : Milestone Release - On Casting of Ground Floor Slab
Komarla Heights Tower B (view from west side) : Second floor slab works are in progress
Komarla Heights Tower B (view from south side) : Second floor slab works are in progress
Tower B (view from top) : Second floor slab works are in progress
Brigade Komarla Heights Club House (view from north side) : Second floor slab concreting completed & Third floor vertical columns casting works are in progress
Brigade Komarla Heights Club House (view from west side) : Second floor slab concreting completed & Third floor columns casting works are in progress
